Purpose

The purpose of this document is to define the conversion approach to load Maintenance Plan Start object in order to Start the Maintenance Plans in S/4 HANA.

The purpose of the Maintenance Plan Start is to initiate the creation of Work Orders based on the criteria specified in the Maintenance Plans.

Maintenance Plans for Syensqo are defined with the purpose of:

  • Preventive Plans - Used for Time Based and Condition based Preventive Maintenance with a defined Strategy
  • Shutdown Plans - Shutdown Plans with a Defined Strategy

Conversion Scope

The conversion scope covers the approach for loading Maintenance Plan Start object in S/4 HANA system.

The data from legacy system includes:

  1. All relevant Maintenance Plans (MPLA-WARPL) in MHIS table, with the next planned call record after the call that has been completed

The data from legacy system excludes:

  1. Inactive Maintenance Plans </Start CR0438>   (System Status TJ02T-TXT04 = INAC JEST-STAT = 'INAC' and  (JEST-INAC <> 'X')  </End CR0438>)
  2. Maintenance Plans (MPLA-WARPL) to be Excluded (Exclusion List Mapping: EXC-Maintenance Plan Start) from getting started

List of Tables to extract for this object is maintained here: Extract Table Register.

List of source systems and approximate number of records

SourceScope

Source Approx No. of Records

Target SystemTarget Approx

No. of Records

PF2, WP2

Relevant Maintenance Plan for Maintenance Plan Start will be extracted from PF2 and WP2, which include the following scenarios (not exhaustive):

  • Legacy Strategy Plans > S/4 Strategy Plans (with no further enrichment in the items and packages)
  • Legacy Single Cycle Plans > S/4 Strategy Plans (with only 1 package assigned)
70,000S/4 HANA70,000
DCT

Maintenance Plan for Maintenance Plan Start for plants which do not have data existing from PF2 and WP2

TBDS/4HANA TBD
DCT

Relevant Maintenance Plan for Maintenance Plan Start for plants which have data existing from PF2 and WP2 which fail pre-load validation during transformation. These data require business decision and may fall under the following example scenarios (not exhaustive):

  • Maintenance Plans in legacy without scheduled calls all the way to the Business Continuity Cutoff Date
  • Legacy Single Cycle Plans > S/4 Strategy Plans  (with more than 1 package assigned)
  • Legacy Strategy Plans > S/4 Strategy Plans (with enrichment in the items and packages)
TBDS/4HANA TBD

Additional Information

Multi-language Requirement

Not Applicable

Document Management

Not Applicable

Legal Requirement

Not Applicable

Special Requirements

Not Applicable

Target Design

The technical design of the target for this conversion approach.

TableFieldData ElementField DescriptionData TypeLengthRequirement
MHISWARPLWARPLMaintenance PlanCHAR12Mandatory
-ZWERKSWERKSPlantCHAR4Mandatory
MHISLRMDTLRMDTDate of Last Completion in Maintenance PlanDATS8Conditional
MHISOFFZEOFFZEOffset with Start in CycleFLTP16Conditional
MHISADUNITDZEIEHUnit for the Performance of Maintenance TasksCHAR3Conditional
MHISRZAEHRZAEHCompletion Counter ReadingFLTP16Conditional
-KEEP-Keep or Delete Calls on HoldCHECKBOX1Conditional
MHISNPLDANPLDANext Planned DateDATS8Display only for validation.

MHIS

ZZAEHLPAKETZAEHLMaintenance Package Number (combined)CHAR40

Display only for reference.

This custom field will contain list of all packages for the next call, separated by a single space (' ')

Data Cleansing

IDCriticalityError Message/Report DescriptionRuleOutputSource System
9001-001C1

Relevant and Active Maintenance Plan is not  scheduled until Business Continuity Cutoff Date.

Active Maintenance Plan is defined by System Status TJ02T-TXT04 <> INAC

Business Continuity Cutoff Date is defined by parameter (MHIS-NPLDA).

Based on all the relevant and active Maintenance Plans in MHIS table, identify what is the latest Plan Date (MHIS-NPLDA). If the date is before the Business Continuity Date parameter, this is an error.

In this example scenario, the latest Plan Date for consideration of this report is 13 September 2026.

Note: Business to either set the Maintenance Plan to Inactive if not required to be started, or schedule the Maintenance Plan until after the Business Continuity Cutoff Date

Maintenance Plan, Plant, Latest Call No, Latest Plan Date

Note: Plant is derived from the planning plant of one of the Maintenance Item (MPOS-IWERK)

PF2, WP2

Note: List of Cleansing is maintained here: Conversion Specs Register (DCT & Cleansing Report)

Conversion Process

The high-level process is represented by the diagrams below.

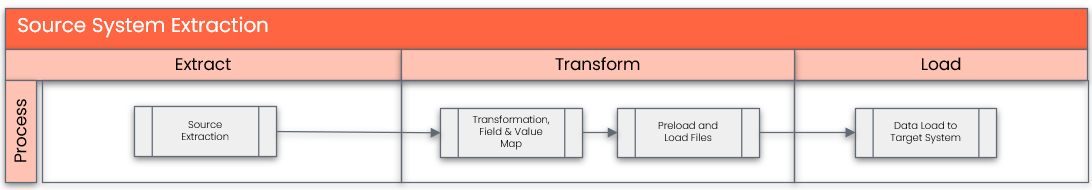

The following represents the high-level process for Source System Extraction:

Relevant Maintenance Plan for Maintenance Plan Start will be extracted from PF2 and WP2, which include the following scenarios (not exhaustive):

  • Legacy Strategy Plans > S/4 Strategy Plans (with no further enrichment in the items and packages)
  • Legacy Single Cycle Plans > S/4 Strategy Plans (with only 1 package assigned)

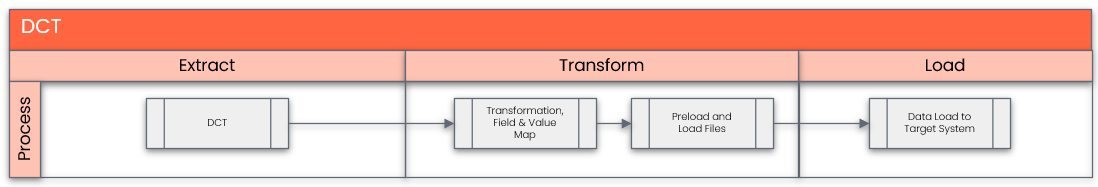

The following represents the high-level process for DCT:

Collection will be done manually in the Data Collection Template for the following scenarios:

  • For sites not on SAP-PF2 or WP2 systems

Collection will be done manually in the Data Collection Template for the following scenarios:

  • Relevant Maintenance Plan for Maintenance Plan Start for plants which have data existing from PF2 and WP2 which fail pre-load validation during transformation. These data require business decision and may fall under the following example scenarios (not exhaustive):

    • Maintenance Plans in legacy without scheduled calls all the way to the Business Continuity Cutoff Date
    • Legacy Single Cycle Plans migrated as S/4 Strategy Plans  (with more than 1 package assigned)
    • Legacy Strategy Plans migrated as S/4 Strategy Plans (with enrichment in the items and packages)

Data Privacy and Sensitivity

Not Applicable.

Extraction

Extract data from a source into Advanced Data Migration and Management (ADMM). There are 2 possibilities:

  1. The data exists. ADMM connects to the source and loads the data into ADMM . There are 3 methods:
    1. Perform full data extraction from relevant tables in the source system(s).
    2. Perform extraction through the application layer.
    3. Only if ADMM cannot connect to the source, data is loaded to the repository from the provided source system extract/report.
  2. The data does not exist (or cannot be converted from its current state). The data is manually collected by the business directly in ADMM . This is to be conducted using DCT (Data Collection Template) in ADMM

The agreed Relevancy criteria is applied to the extracted records as reference point to identify the records that are applicable for the data construction in the DCT.

Extraction Run Sheet

Req #Requirement DescriptionTeam Responsible
1Extract data from source system based on relevancy ruleSyWay Data Team
2Google Sheet report pre-populated with PF2 and WP2 information to be generated based on relevancy criteria. SyWay Data Team

Selection Screen

Selection Ref ScreenParameter NameSelection TypeRequirementValue to be entered/set
Not Applicable

Data Collection Template (DCT)

Target Ready Data Collection Template will be created for Maintenance Plan Start data with exception of some fields which require transformation as mentioned in the transformation rule.

  1. The extracted report will be loaded into the required structure using the DCT.
  2. Standardization activities (including deduplication, standardization and additions)  will be carried out within the DCT.

Delta Data Management: Initial collection will be done via the report and one-time load to the DCT will be performed. Any delta after the initial collection within the DCT will require business to take due diligence to ensure any subsequent delta cleansing is verified and aligned within the DCT.

Note: All rules specified below should be documented as a tooltip in the DC Page.

Format:

  • Line 1: Mandatory / Conditional
  • Line 2: Remaining text

1. Maintenance Plan Start Data Construction Rules

Field NameField DescriptionRule
zLegacyWARPLMaintenance Plan Identifier

Mandatory

Must either exist in legacy (for PF2/WP2 data), or exist in Maintenance Plan DCT.

ZWERKSPlant

Mandatory

Allowed values: List from Value Mapping - Plant where Maintenance Plant = Yes

Must be valid Planning Plant associated with the Maintenance Plan.

LRMDTDate of Last Completion in Maintenance Plan

Conditional

Mandatory if the Maintenance Plan is Time Based.

Leave blank if the Maintenance Plan is Performance Based.

Must be in DDMMYYYY format

OFFZEOffset with Start in Cycle

Conditional

Populate if offset is required.

Allowed values: Numeric values more than 0.

Leave blank if offset is not required.

ADUNITUnit for the Performance of Maintenance Tasks

Mandatory

Allowed values: Valid UOM from T006.

Must align with the Cycle Unit of the Maintenance Plan.

RZAEHCompletion Counter Reading

Conditional

Mandatory if the Maintenance Plan is Performance Based.

Leave blank if the Maintenance Plan is Time Based.

KEEPKeep or Calls on Hold

Leave blank

This field is only required if the Maintenance Plan needs to be rescheduled and there are existing calls on hold.

X = Keep Calls on Hold.

Blank = Delete Calls on Hold.

2. Maintenance Plan Start Exclusion Data Construction Rules

Field NameField DescriptionRule
zLegacyWARPLLegacy Maintenance Plan

Mandatory

Must exist in legacy (PF2/WP2)

Note to developer: This is the key field

zLegacyWERKSLegacy Plant

Mandatory

Allowed values: List from Value Mapping - Plant where Maintenance Plant = Yes

Legacy Planning Plant associated with the Legacy Maintenance Plant

Note to developer: This is the key field

COMMENTComment

Mandatory

Populate requirement for Exclusion

Note to developer: This is NOT the key field, but make this mandatory in the DCT

Note: List of DCTs is maintained here: Conversion Specs Register (DCT & Cleansing Report)

Extraction Dependencies

Item #Step DescriptionTeam Responsible
1Relevancy Criteria for Maintenance Plan and ItemSyWay Data Team

Transformation

The Target fields are mapped to the applicable Legacy field that will be its source, this is a 3-way activity involving the Business, Functional team and Data team. This identifies the transformation activity required to allow ADMM to make the data Target ready:

  1. Perform value mapping and data transformation rules.
    1. Legacy values are mapped to the to-be values (this could include a default value)
    2. Values are transformed according to the rules defined in ADMM
  2. Prepare target-ready data in the structure and format that is required for loading via prescribed Load Tool. This step also produces the load data ready for business to perform Pre-load Data Validation

Transformation Run Sheet

Item #Step DescriptionTeam Responsible

1

Obtain DCT Sign-off from Business.

SyWay Data Team

2

In dspMigrate, select the wave – S4/HANA – Plant Maintenance

Syniti

3

Go to Process Area Launch and Process the Object – Maintenance Plan Start

Syniti

4

Review and Validate Error and Preload Reports

Syniti

5

Execute the transformation to prepare the target tables

Syniti

6

Validate data from pre-load and error reports

Business/Data owner

7

Populate DCT for records which need business decisions (if required)

Business/Data owner

8

Repeat steps 1-7 as required to allow business the opportunity to add additional records into the DCT based on validations performed during transformation

Syniti

9

Generate load files

Syniti

Transformation Rules

1. Maintenance Plan Start (DCT)

Rule #Source systemSource TableSource FieldSource DescriptionTarget SystemTarget TableTarget FieldTarget DescriptionTransformation Logic
1DCTMHISzLegacyWARPLMaintenance Plan IdentifierS/4 HANAMHISWARPLMaintenance PlanValue Mapping: Maintenance Plan
2DCT-ZWERKSPlant--ZWERKSPlantValue is not for loading, only for validation.
3DCTMHISLRMDTDate of Last Completion in Maintenance PlanS/4 HANAMHISLRMDTDate of Last Completion in Maintenance PlanDirect Mapping
4DCTMHISOFFZEOffset with Start in CycleS/4 HANAMHISOFFZEOffset with Start in CycleDirect Mapping
5DCTMHISADUNITUnit for the Performance of Maintenance TasksS/4 HANAMHISADUNITUnit for the Performance of Maintenance TasksDirect Mapping
6DCTMHISRZAEHCompletion Counter ReadingS/4 HANAMHISRZAEHCompletion Counter ReadingDirect Mapping
7DCT-KEEPKeep or Calls on HoldS/4 HANA-KEEPKeep or Delete Calls on HoldDirect Mapping
8------NPLDANext Planned DateBlank
9------ZZAEHLMaintenance Package Number (combined)Blank

2. Maintenance Plan Start (ECC)

Note: MHIS table contains all the maintenance plan calls (multiple records per Maintenance Plan). To load Maintenance Plan Start, only the latest completion must be considered.

Selection criteria for transformation of records from MHIS table. Based on relevant Maintenance Plan Start (WARPL):

  1. Select the earliest record(s) where Completion Date (MHIS-LRMDT) is null, order by Call Number (MHIS-ABNUM)
  2. If there are more than one record with the same Call Number, then select the first record, and combine the multiple package numbers (MHIS-ZAEHL) into one field (ZZAEHL) separated by single space (' ')

Scenario for extraction from MHIS Table is illustrated in this example:

  1. Based on the earliest record(s) where Completion Date is null, call number 9 should be extracted for this Maintenance Plan.
  2. In this instance, the next planned date should be 18 June 2026, and the Maintenance Package Number should be "01 02 03"
  3. For the Last Completion Date (MHIS-LRMDT) - select the Completion Date of the previous call (which is call number 8) - which is 15 December 2025

Rule #Source systemSource TableSource FieldSource DescriptionTarget SystemTarget TableTarget FieldTarget DescriptionTransformation Logic
1PF2, WP2MHISWARPLMaintenance PlanS/4 HANAMHISWARPLMaintenance PlanValue Mapping: Maintenance Plan
2------ZWERKSPlantDerive the Planning Plant (MPOS-IWERK) from one Maintenance Item of the Maintenance Plan
3PF2, WP2MHISLRMDTDate of Last Completion in Maintenance PlanS/4 HANAMHISLRMDTDate of Last Completion in Maintenance Plan

For Time Based Plan: Direct Mapping - select the Completion Date of the Previous Call

For Performance Based Plan: Default to Blank

4PF2, WP2MHISOFFZEOffset with Start in CycleS/4 HANAMHISOFFZEOffset with Start in Cycle

Floating point conversion  conversion from SI unit.

Consider the unit from (ADUNIT) and compare against table T006 for conversion.

Explanation for conversion from SI Unit:

a) Based on the UOM of the ADUNIT, retrieve record from T006-MSEHI

b) With the value:

> Dividy by ZAEHL, and

> Multiply by NENNR

5PF2, WP2MHISADUNITUnit for the Performance of Maintenance TasksS/4 HANAMHISADUNITUnit for the Performance of Maintenance TasksDirect Mapping
6PF2, WP2MHISRZAEHCompletion Counter ReadingS/4 HANAMHISRZAEHCompletion Counter Reading

For Performance Based Plan:

Select the Completion Counter Reading of the Previous Call

Floating point conversion  conversion from SI unit.

Consider the unit from (ADUNIT) and compare against table T006 for conversion.

Explanation for conversion from SI Unit:

a) Based on the UOM of the ADUNIT, retrieve record from T006-MSEHI

b) With the value:

> Dividy by ZAEHL, and

> Multiply by NENNR

For Time Based Plan: Default to Blank

7PF2, WP2-KEEPKeep or Delete Calls on HoldS/4 HANA-KEEPKeep or Delete Calls on HoldDefault to blank
8PF2, WP2MHISNPLDANext Planned Date--NPLDANext Planned Date

For Time Based Plan: Direct Mapping

Value is not for loading, only for validation.

For Performance Based Plan: Default to Blank

9PF2, WP2MHISZZAEHLMaintenance Package Number (combined)--ZZAEHLMaintenance Package Number (combined)

For Time Based Plan: Combine the multiple package numbers separated by single space (' ')

Value is not for loading, only for reference.

For Performance Based Plan: Default to Blank

Note:

  1. Time Based Plan is defined by (S/4 SAP) MPLA-STICH  = Blank, 1 or 2
  2. Performance Based Plan is defined by (S/4 SAP) MPLA-STICH = 3

List of Custom Target Reports for this object is maintained here: Conversion Specification - Custom Reports Register.

Transformation Mapping

Mapping Table NameMapping Table Description
EXC-Maintenance Plan Start

Exclusion List of Maintenance Plans to be Started

Maintenance Plan

Old to new Maintenance Plan

Plant

Mapping of legacy Plant to new Plant

List of Transformation Mappings with additional details is maintained here: Transformation Mappings

Transformation Dependencies

List the steps that need to occur before transformation can commence
Item #Step DescriptionTeam Responsible

1

Ensure DCT tables completeness

SyWay Data Team

2

Ensure all Transformation mappings are up to date.

SyWay Data Team

Pre-Load Validation

Project Team

Completeness

TaskAction
Verify Record CountSyWay A2D Data Team to verify that the total number of relevant records from the  DCT is equal to the total number of records in the Preload and Load Sheets.

Accuracy

TaskAction
Conversion Accuracy

SyWay A2D Data Team to verify that all fields below meet pass the checks:

  1. Mandatory Fields
  2. Field and Value Mapping Correctness
  3. Null Checks
  4. Text Length Checks
Review Error ReportsReview and correct the errors.  Achieve a zero-error record count as much as possible. Raise defects for data remediated and requiring a correction in the source data.

Business

Completeness

TaskAction
Verify Record CountBusiness Data Owner/s to verify that the total number of relevant records from the the DCT is equal to the total number of records in the Preload and Load Sheets.

Accuracy

TaskAction
Conversion AccuracyBusiness Data Owner/s to verify that all the data in the load table/file is accurate as per endorsed transformation/mapping rules (and signed-off DCT data).

Load

The load process includes:

  1. Execute the automated data load into target system using load tool or product the load file if the load must be done manually
  2. Once the data is loaded to the target system, it will be extracted and prepared for Post Load Data Validation

Load Run Sheet

Item #Step DescriptionTeam Responsible

1

Ensure Pre-load sign-offs are obtained.

SyWay Data team

2

Go to the load tool and select the correct load Program.

SyWay Data team

3

Proceed with Data load.

SyWay Data team

4

Validate few records loaded by accessing standard transactions

SyWay Data team

5

Generate the post load reports in the tool.

SyWay Data team

6

Log errors as defects, if any and address resolutions. Close defects.

SyWay Data team

7

Resolve defects by reupload and re-generate post load reports if necessary.

SyWay Data team

8

Business to validate the post load files as part of post-load validation, raise data defects or provide the post-load sign-off.

Business

9

Repeat steps 5 to 7 if necessary.

SyWay Data team

Load Phase and Dependencies

Cutover

Configuration

Item #Configuration Item

Not Applicable

Conversion Objects

Object #Preceding Object Conversion Approach
1016Maintenance Plan and Item
9002Measurement Document

Error Handling

Error TypeError DescriptionAction Taken

Invalid Data

Invalid Maintenance Plans and Items

Expedite whether the master data is available in the system

Post-Load Validation

Project Team

Completeness

TaskAction

Verify Count

SyWay A2D Data Team to verify the record count created in target S/4 HANA by accessing post load reports in dspMigrate or standard reports from S/4 HANA.

Verify Logs

Check if there is data that failed to load and perform the necessary actions (e.g. register as post load issue or attempt to load the record again, etc.).

Accuracy

TaskAction

Conversion Accuracy

Verify that the EAM Maintenance Plant Start data in target S/4 HANA were loaded correctly via dspMigrate post load reports or standard reports from S/4 HANA.

Business

Completeness

TaskAction

Verify Count

Download Post Load Reports from dspMigrate and verify that the record count loaded in the target S/4 HANA is the same count as of the endorsed load file.

Accuracy

TaskAction

Conversion Accuracy

Verify that the EAM Maintenance Plant Start data in target S/4 HANA were loaded correctly via dspMigrate post load reports or standard reports from S/4 HANA.

Key Assumptions

  • Maintenance Plan Start is in scope based on data design and any exception requested by business.
  • Data cleansing has met the required percentage threshold for the specified mock cycle and all preparation activities have been completed.
  • Data entries in DCT are target-ready data unless a specific transformation rule is stated for that field in the transformation rules.
  • All Maintenance Plans to be started in S/4 are Strategy Based Plans.
  • Multiple Counter Maintenance Plans are not in scope.
  • Manual starting of Maintenance Plans are not in scope.
  • For Starting of the Performance Based Maintenance Plans in S/4, no validations are performed at this point to verify if the next call date is after Business Continuity Cutoff Date. More data needs to be analysed to define the validation and will be performed after the Mock cycles are completed.
  • Proposed target design follows the structure of Function Module: MPLAN_START_CYCLE

See also

Change log

Version Published Changed By Comment
CURRENT (v. 102) Apr 13, 2026 08:30 PUN-ext, Eddy CR0438 - Active (JEST-INAC <> 'X')
v. 101 Apr 13, 2026 08:03 PUN-ext, Eddy
v. 100 Apr 07, 2026 10:20 PUN-ext, Eddy
v. 99 Apr 07, 2026 10:18 PUN-ext, Eddy
v. 98 Mar 03, 2026 12:18 ERGUIZA-ext, Pinky Love
v. 97 Feb 19, 2026 11:00 PUN-ext, Eddy
v. 96 Feb 19, 2026 10:57 PUN-ext, Eddy
v. 95 Feb 19, 2026 10:55 PUN-ext, Eddy
v. 94 Feb 19, 2026 10:50 PUN-ext, Eddy
v. 93 Jan 28, 2026 15:13 PUN-ext, Eddy

Go to Page History
