SBS-OP-DRTR-02-075 - I create R&D WBS

Responsibility area: Master data management

This document describes the transactions related to the process of R&D project creation.

The R&D projects aims to track costs of R&D projects. In order to facilitate the capitalization of qualifying R&D projects, a time and cost-tracking system has been created using WBS (Work Breakdown Structure) in the accounting ERP system (SAP).

Scope

PF1
Frequency

References


Error rendering macro 'contentbylabel'

parameters should not be empty

Attachments

SBS-FRM-DRTR-02-019 - R&D Project Creation Template.xlsx

xx << SBS-OP-DRTR-02-075 - I create R&D WBS >> xx



  Guideline

The codification of the R&D project must follow the standard rule detailed below:

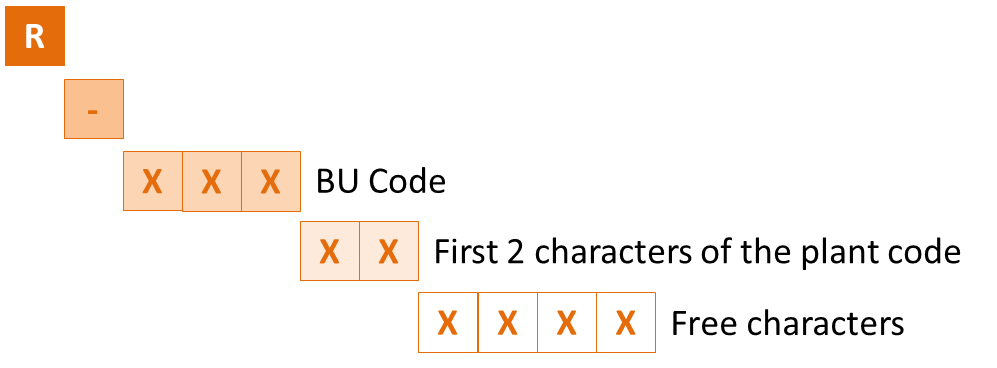

The codification of a R&D project is



  • R
  • -

BU code

GBUName
U01Essential Chemicals (Solvay Legacy)
U02Special Chemicals (Solvay Legacy)
U03Vinyls (Solvay Legacy)
U04Plastics Integration (Solvay Legacy)
U05Specialty Polymers
U06CBS & NBD
U07Olefins (Solvay Legacy)
U09Rhodia
U10Peroxides (Solvay Legacy)
U11Soda Ash (Solvay Legacy)
U12Engineering Plastics (obsolete)
U13Polyamides & Intermediaires (obsolete)
U14Novecare
U15Silica (Solvay Legacy)
U16Aroma
U17Performance Polyamides



STEP 1

Enter Transaction CJ01

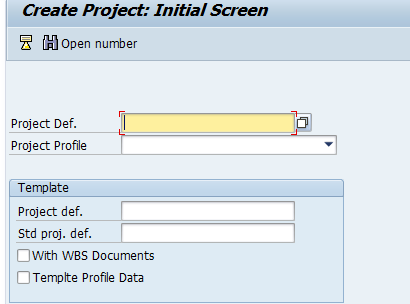

STEP 2

Insert the project definition and choose the project profile according to the plant of the company. This information is available in the template received.

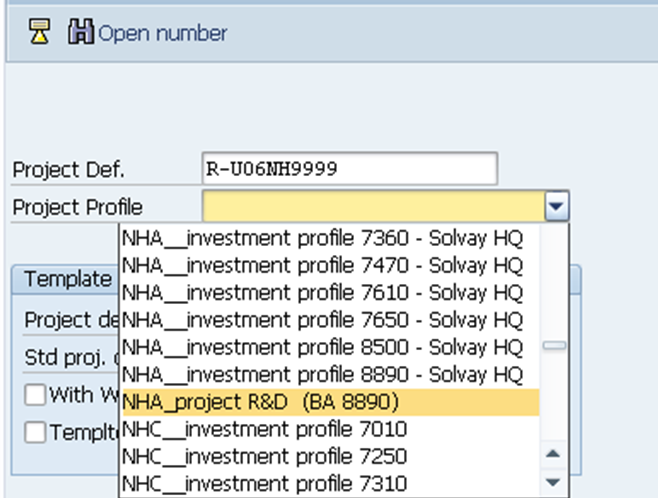

The Project Profile should be always “ XXX_project R&D (BA XXXX)”.






STEP 3

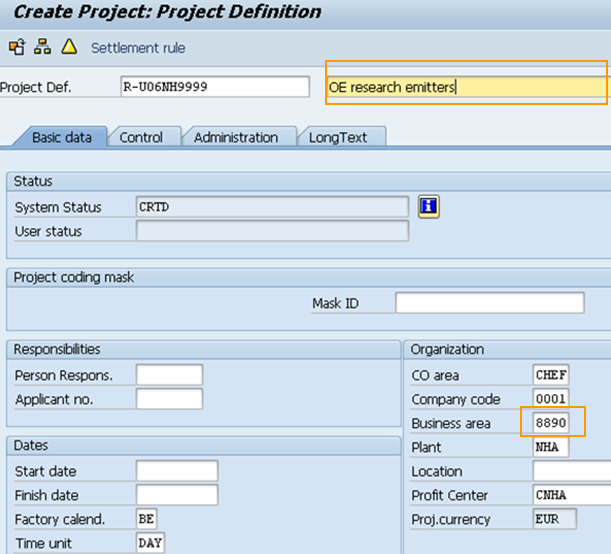

  • Include the Project Name send in the template
  • Check if the Business Area is correctly filled.








STEP 4

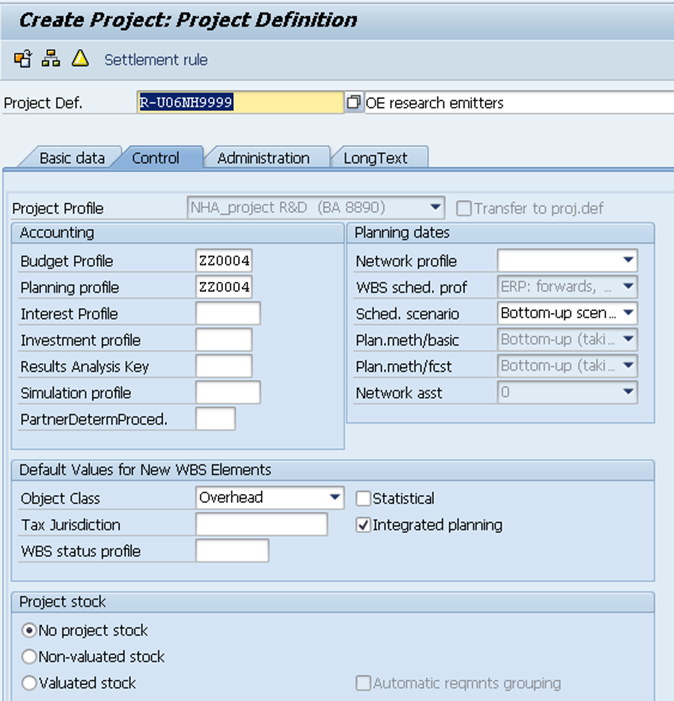

Enter the Control tab in order to confirm that the object class is “Overhead”.

  • Click on the WBS overview





STEP 5

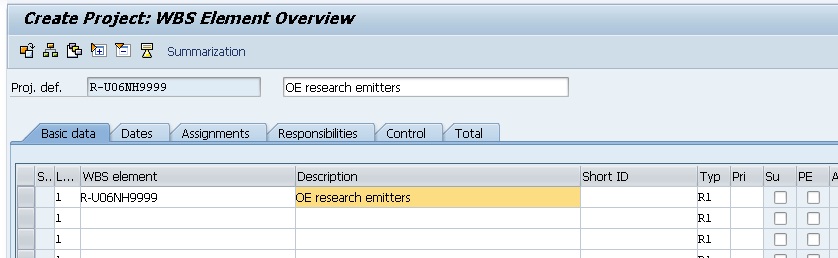

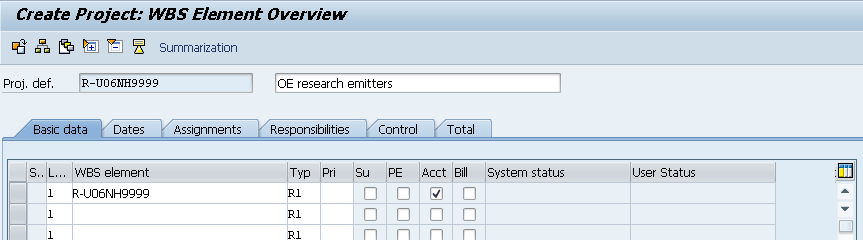

  • Fulfill the level 1of the WBS by inserting the WBS element and Description as per the received template.




STEP 6

  • Flag the "Acct" Column.
  • Column ''Typ'' is set by default to R1. Change it only if it's mentioned in the template file.






STEP 7

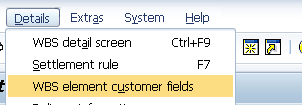

  • Go to Details menu and enter in WBS element customer fields.




STEP 8

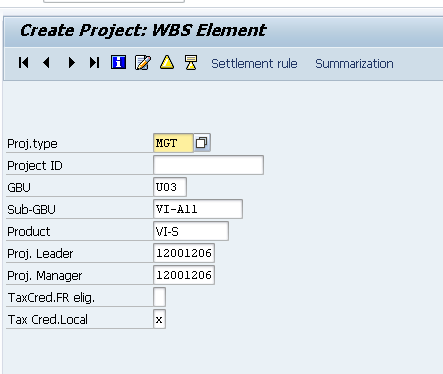

Fill in the following fields, as per template:

  • Proj. type
  • GBU
  • Sub-GBU
  • Product
  • Proj. Leader
  • Proj. Manager
  • Tax Cred. Local



Note that the selection of the correct Project Type is very important when creating the WBS element, as it will have impact in some reports, namely CosTa and Capex ones.

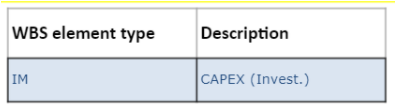

In order to be considered Capex (both for CosTa and Capex Dashboard) the Project Type must be the one below:




STEP 9

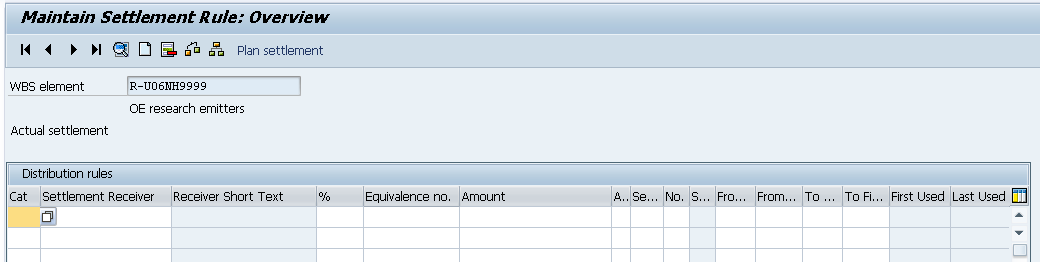

Click on , in order to define the settlement rule of the WBS.




STEP 10

Click twice on the first line.






STEP 11

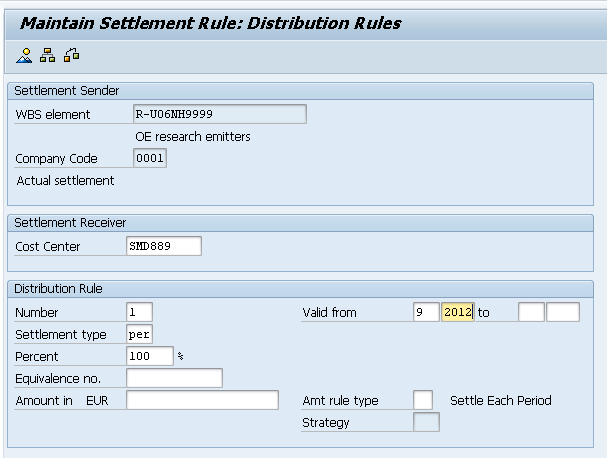

Fill in the following fields:

  • Cost Center – (received in the template)
  • Number – Usually 1, this field should be adapt according to the number of receivers
  • Settlement type – PER
  • Percent – Usually 100% it’s variable according to the number of receivers
  • Valid from – month and year of the creation of the WBS

In the end go back by pressing until you arrive to the WBS first screen.




STEP 12

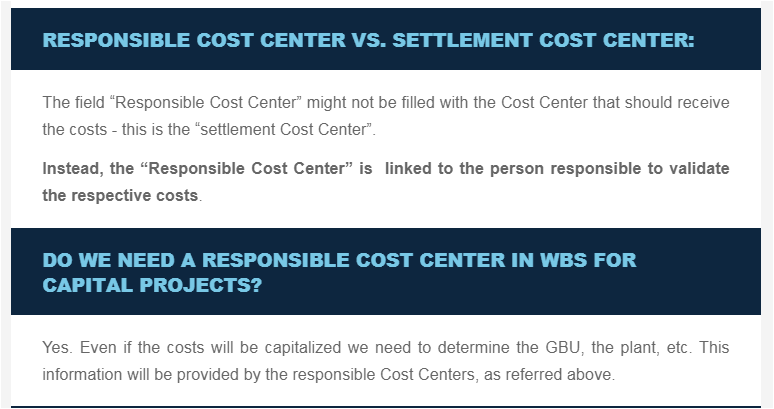

Important fields of the master data that will have an impact for CosTa Dashboards. NOTE: The "responsible CC" is not mandatory for Projects or WBS levels WITHOUT a flag in the operative indicator of "Account Assignment Element".




STEP 13

In order to release the WBS,  you have to go to Edit > Status > Release.

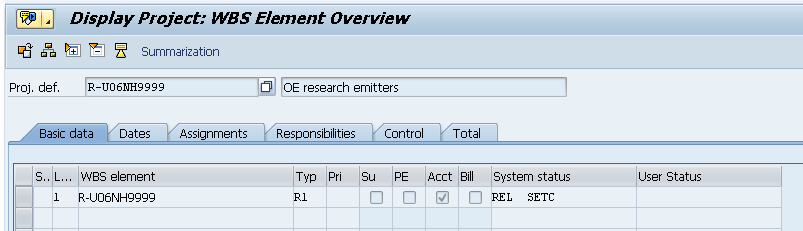

Check if the status is now REL and SETC.






STEP 14

The WBS is now ready to be saved






STEP 1

Analyse the document sent.

If there is any AUC in column "Settlement Receiver" it should be deleted because it will be fulfilled automatically by the transaction.






STEP 2

Enter transaction ZZJ02

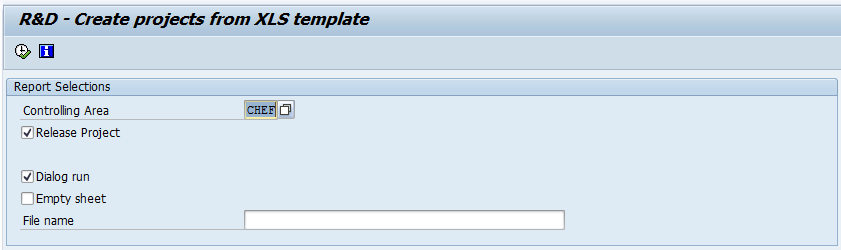

STEP 3

Deselect the field “Release Project”.






STEP 4

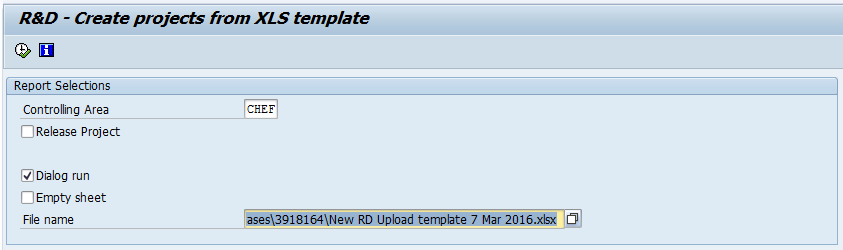

In the "File name" field, upload the Excel file received








STEP 5

Click on the ''Execute''  in order to get to the following screen.

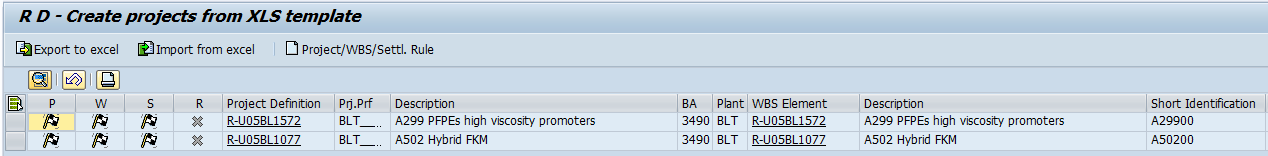

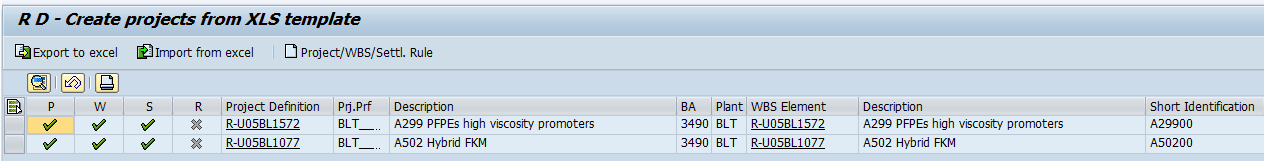

The information that is available on the chosen Excel file, is not displayed.

The first 4 columns stand for:

P: Project / W: WBS / S: Settlement rule /R: Release



The "Release" column can have 4 different status:

Ready to be created
Created
Error in creation
Completed






STEP 6

Select one or several lines and click on  in order to create a new project.






STEP 7

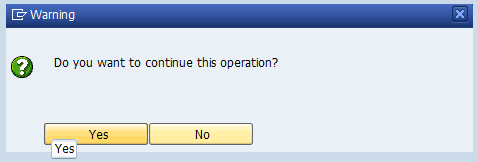

Click on ''OK'' when the warning message pops-up.






STEP 8

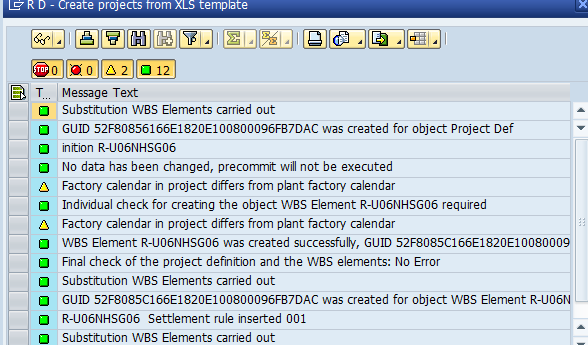

If no errors will be found, a similar screen will be displayed.

Click on  to continue.

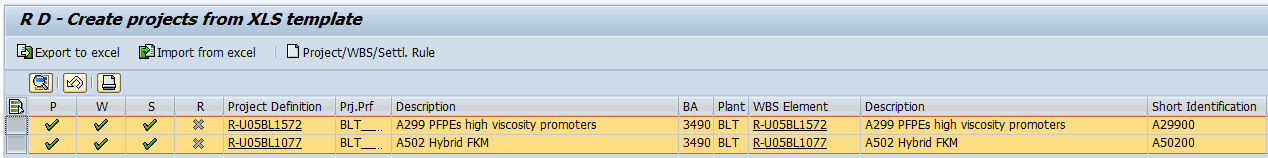

The project created will show a flag  in columns P, W and S.



I send an e-mail to the Controller in order to obtain the confirmation or validation that everything is OK in project creation process, in order to perform the release.

  • Click on ''Back'' (F3)
  • When the warning message appears, click on ''Yes''.
  • Tick the''Release project'' field.


Send an e-mail to the Controller confirming that the R&D WBS was created and release.
